How to Build a Sprint Burndown Chart (Using the Template)
The burndown chart shows how much work remains in a sprint and helps you see if the team is on track. This guide walks you through filling in the provided Excel template and producing a clean, useful burndown.
Burned Down Planned – How many story points you plan to finish that day.
Burned Down Actual – How many story points the team actually finished that day.
Balance Planned – Remaining story points if you follow the plan.
Balance Actual – Remaining story points based on actual progress.
Before You Start
Total sprint scope (sum of story points you committed at Sprint Planning).
Sprint length (number of calendar or working days you want to track).
Daily capacity plan (how many points you intend to complete each day—can be even or varied).
Step 1 — Set Sprint Length
Open the template and look at the Day column.
Extend or trim the list so it covers your sprint (e.g., Day 0 to Day 10 for an 11-day sprint).
If you don’t work weekends, you can still keep the days; just plan 0 for those dates (see next step).
Step 2 — Enter the Total Scope on Day 0
In Balance Planned for Day 0, enter the total story points (e.g., 460).
In Balance Actual for Day 0, enter the same total (e.g., 460).
This sets the starting point for both the planned and actual lines.
Step 3 — Plan Your Daily Burn
Fill the Burned Down Planned column for each sprint day (not Day 0). You have two common options:
Even plan: total_scope ÷ number_of_days (e.g., 460 ÷ 23 ≈ 20 per day). Put that daily number in each row.
Capacity-based plan: assign different planned values per day (e.g., 0 on weekends, higher on big-focus days).
Step 4 — Let the Planned Balance Calculate
Use a simple running subtraction so planned remaining work drops as planned burn occurs. If your headers are in row 1 and data starts in row 2, columns are typically:
A: Day
B: Burned Down Planned
C: Burned Down Actual
D: Balance Planned
E: Balance Actual
Typical formulas (adapt to your sheet rows if needed):
In D2 (Day 0): enter your total scope (e.g., 460).
In D3 (Day 1): =D2 - B3, then copy down the column.
Step 5 — Track Actual Burn Daily
Each day, enter what was truly completed in Burned Down Actual for that day (column C).
Let Balance Actual recalculate using a running subtraction. Typical setup:
In E2 (Day 0): enter your total scope again (e.g., 460).
In E3 (Day 1): =E2 - C3, then copy down the column.
Step 6 — Create (or Refresh) the Chart
Select the Day column and both Balance Planned and Balance Actual columns (Day vs. the two balances).
Insert a Line chart (or “Line with markers”).
Ensure the X-axis is Day and the two series are Balance Planned and Balance Actual.

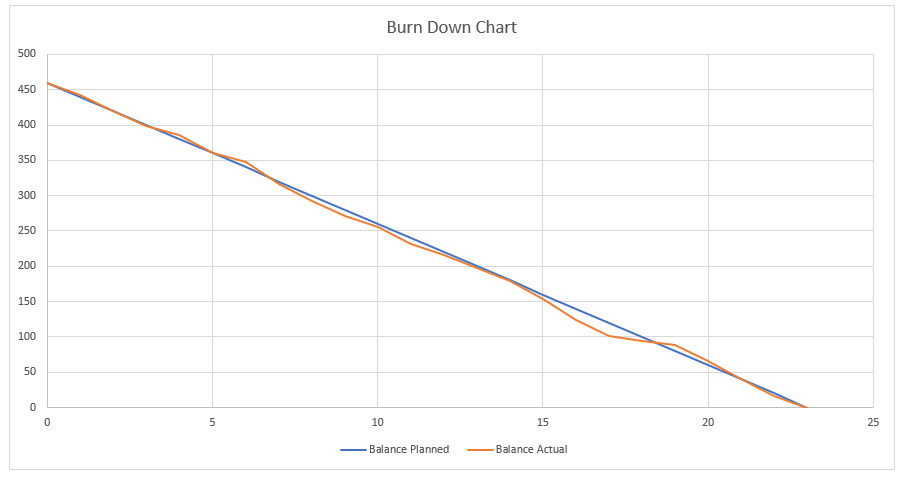

Give the chart a clear title (e.g., “Sprint 14 Burndown”).
How to Read the Chart
Balance Planned should slope steadily down to 0 by the last day.
Balance Actual shows reality. If it stays above the plan, you’re behind; if it’s below, you’re ahead.
Handling Common Real-World Situations
Weekends / Holidays: Put 0 in Burned Down Planned for those days. The planned line will flatten accordingly.
Scope increase (new story points added): Add a negative value in Burned Down Actual on the day scope changed (e.g., -20). This raises the actual balance line, showing more work remaining.
Scope decrease (stories removed): Add that amount as a positive value in Burned Down Actual (e.g., +15) to reduce remaining work appropriately.
Partial completions: Only count story points when the story meets your “Done” definition. Avoid burning partials unless your team explicitly agrees to do so.
Quality Checks
The last planned balance (last day in Balance Planned) should be 0 if you planned to finish the entire scope.
The last actual balance (last day in Balance Actual) shows what truly remains. If it’s not 0, discuss carryover at Sprint Review/Retrospective.
If balances don’t update, re-check that the formulas reference the correct rows.
Optional Refinements
Labels: Add data labels to show remaining points on key days.
Target line: Keep Balance Planned as your “ideal” line; it’s already serving as the target.
Working days only: You can list only working days in the Day column; just ensure plan/actual balances run correctly.
Daily Routine to Keep It Useful
At day’s end, update Burned Down Actual with the points truly completed.
Confirm the chart looks right (actual line trending toward 0).
Call out scope changes so the team understands why the line moved.
Tips for Better Forecasting
Use the burndown trend to spot risk early (flat or rising actual line needs attention).
Discuss blockers each day; remove them quickly to restore burn rate.
Keep planned burn realistic; adjust next sprint’s plan using recent velocity.
Summary
Populate Burned Down Planned with your daily plan, log real progress in Burned Down Actual, and let the template calculate Balance Planned and Balance Actual. The chart then tells the story: if the actual line tracks the plan, you’re on pace; if not, investigate and adapt. Keep it updated daily, and your sprint visibility will improve dramatically.
Day
Burned Down Planned
Burned Down Actual
Balance Planned
Balance Actual
0
460
460
1
20
18
440
442
2
20
22
420
420
3
20
22
400
398
4
20
12
380
386
5
20
25
360
361
6
20
14
340
347
7
20
30
320
317
8
20
25
300
292
9
20
21
280
271
10
20
16
260
255
11
20
23
240
232
12
20
16
220
216
13
20
18
200
198
14
20
19
180
179
15
20
25
160
154
16
20
30
140
124
17
20
23
120
101
18
20
7
100
94
19
20
6
80
88
20
20
22
60
66
21
20
25
40
41
22
20
25
20
16
23
20
16
0
0
How To Land the Job and Interview for Project Managers Course
Take the next big step in your project management career with HK School of Management. Whether you're breaking into the field or aiming for your dream job, this course gives you the tools to stand out, impress in interviews, and secure the role you deserve.
This isn’t just another job-hunting guide—it’s a tailored roadmap for project managers. You’ll craft winning resumes, tackle tough interview questions, and plan your first 90 days with confidence. Our hands-on approach includes real-world examples, AI-powered resume hacks, and interactive exercises to sharpen your skills.
You'll navigate the hiring process like a pro, with expert insights on personal branding, salary negotiation, and career growth strategies. Plus, downloadable templates and step-by-step guidance ensure you're always prepared.
Learn from seasoned professionals and join a community of ambitious project managers. Ready to land your ideal job and thrive in your career? Enroll now and take control of your future!
HK School of Management helps you learn Agile and Scrum with practical playbooks, AI-powered prompts, and real-world workflows for planning and delivery. Practical skills, tools, and guidance you can apply right away. Covered by Udemy's 30-day refund policy.
